BidQwik.com
Have
a question we have not answered? Send us an email - SEND
|
Your product
works with Microsoft's Excel. I have Excel as part of my
Office suite of products but do not have the time or the desire
to learn how to really use this
program.
Should I skip your product and look for something similar that
is easier to use? |
|
I
have a service and associated product material; what should I sell it for? |
|
What
profit does my competitor have on the same service & product
we provide? |
|
I
get $944.08 profit on each product I sell, is this a moneymaker? |
|
Does
the product cost change if my company asks me to sell the product
at a specific price or gross margin? |
|
My
company wants to make good profit but does not insist on a specific
GMP or sell price. They rely on me to set the sell price. However,
my costs are not fixed. In addition to the usual material & labor
costs, I sometimes need to pay parking and subcontractor costs,
other times I pay only freight charges. How does this affect the
GMP? |
|
Assume
I bid a project at a specific sell price, and downstream I find
additional costs that I did not count on. How will this
affect GMP? |
|
So
if I use lower raw-labor rate people to complete the job, the increased
costs mentioned above may be offset by the cost decreases
from labor? |
|
How
does your cost chart work in TrakPro? |
|
Along
that same line as question #8 above, how does TrakPro handle the
estimate-to-complete (ETC) cost projection? |
|
In
TrakPro, what is the "Over/Under Minimum Billing Amount" and
what is it used for? |
|
In
TrakPro, what is the function of the WIP Sheet? |
|
I
have many technicians (at different pay grades), many products,
different configurations, variable timeframes and more. How do
I calculate the sell, GMP, billing and cash position numbers easily
and quickly? |
|
A

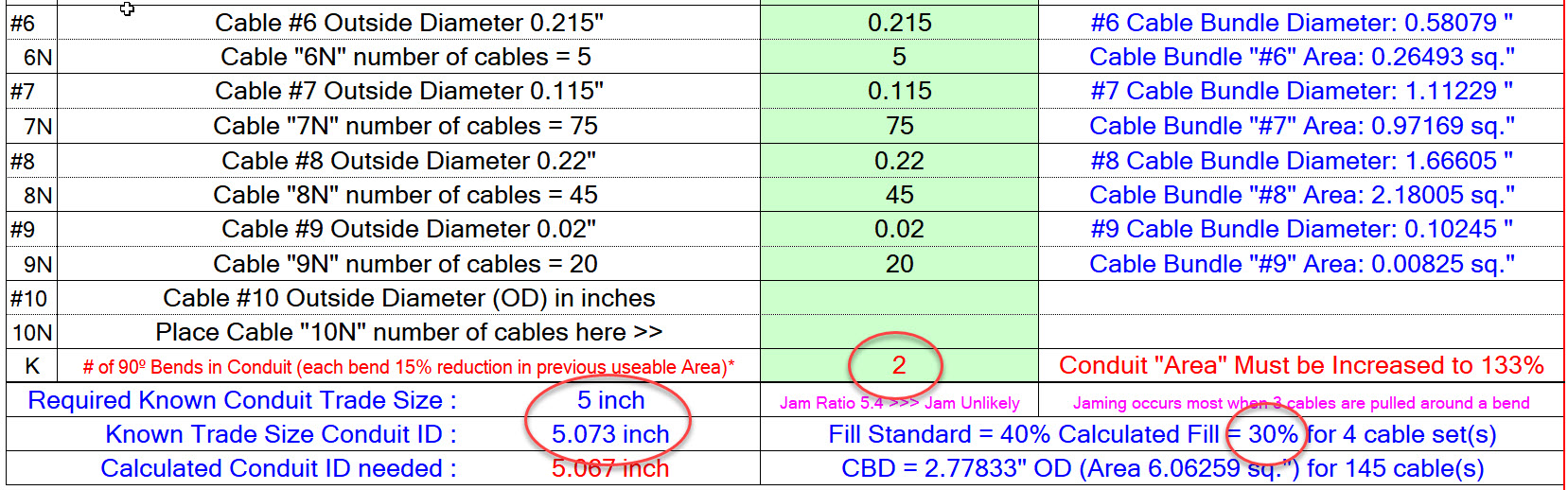

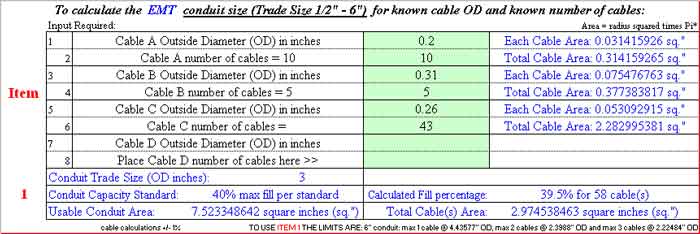

3" diameter EMT conduit we want to use already has 2 sets
of cables (10 cables @ 0.2" dia and 5 cables @ 0.31" dia).
We want to add 43 cables @ 0.26" dia. Will we still be to
standard at the 40% max fill? |
|
Please
help with the bid price for the following: 525 new CAT6 V/D runs
and 25 new fiber locations. All are at an average 200' distance
from the MDF except 3 fiber runs that are 250 feet station distance.
All voice/data/fiber cables land on patch panels. The
CAT6 cable costs me $0.23 per foot, the multimode fiber cable
is $0.38 per
foot, the rack is $180. The 96 port data panels cost $878.40
each, 12 port data panels $121.80 and the 48 port fiber patch
panel is $134.40 each (with couplers only,unterminated). I mark
up my material 20% and my burdened labor is $26.00 per hour and
the labor sell price is around $54.00 per hour.The customer wants
20% growth on the panels. Can you help?
|
|
I
notice many questions relate to computer cabling projects, does
your software handle different business projects? |
|
Do
I need to update your programs regularly to keep them current?
Do I need to buy additional copies or licenses to run your program
on my work and home computers? |
|
Your
logo is a moon overlooking the earth. Is there any significance
to that? |
|
Peter

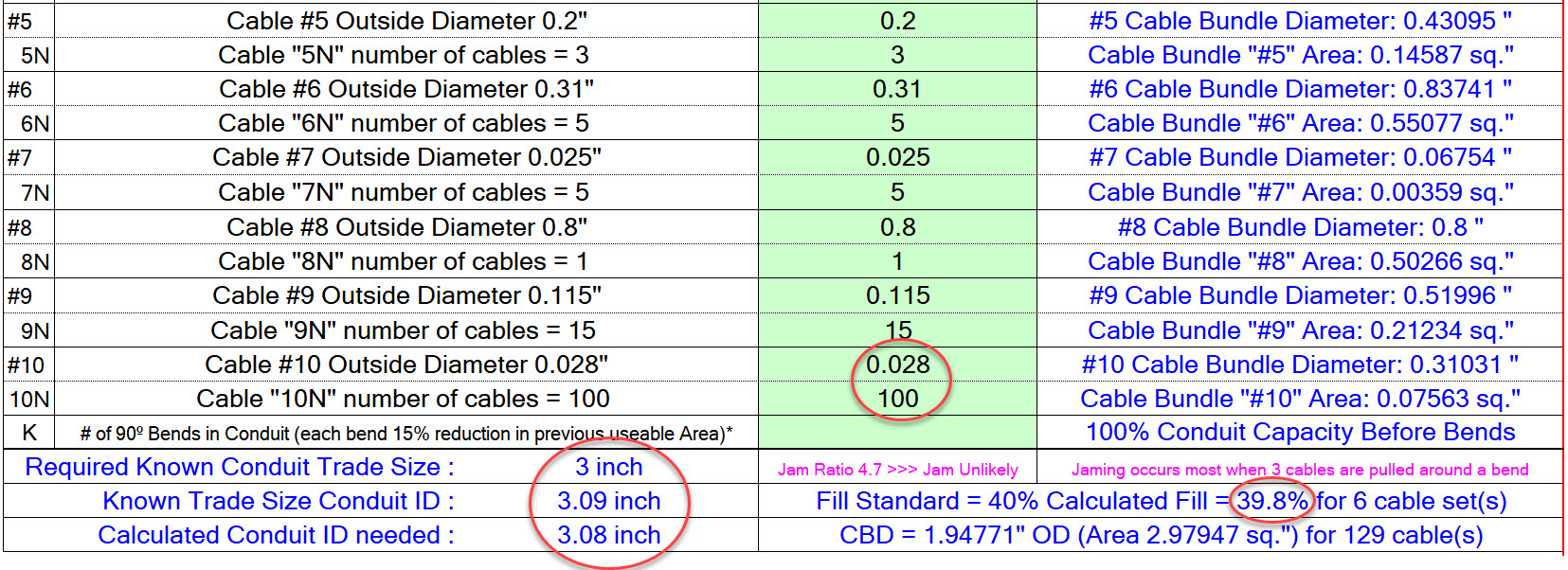

we have a 5" EMT conduit that has the following existing

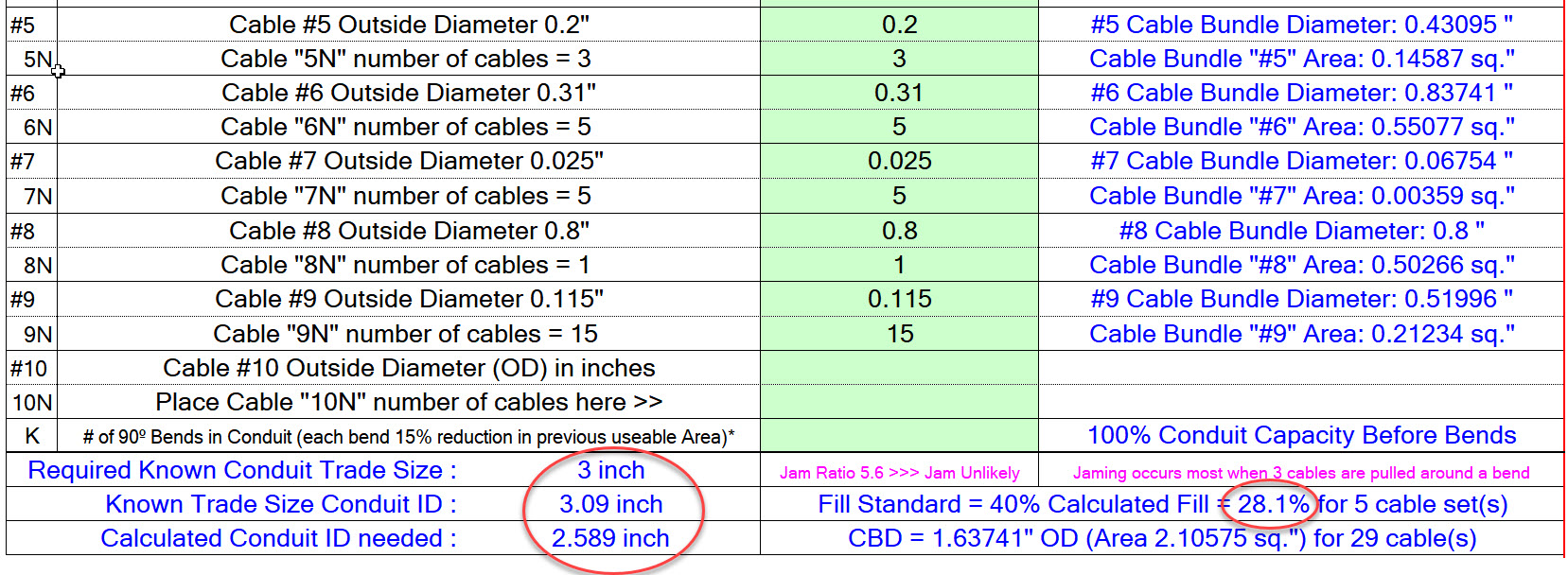

cables (50-0.215" OD, 75-0.115" OD and 45-0.30" OD).
We want to add 45-0.24" cables to this conduit, will we still
be to the 40% maximum fill standard? We see that your "Peter's
Fill" sheet has the multi-cable calculations but not the EIA/TIA

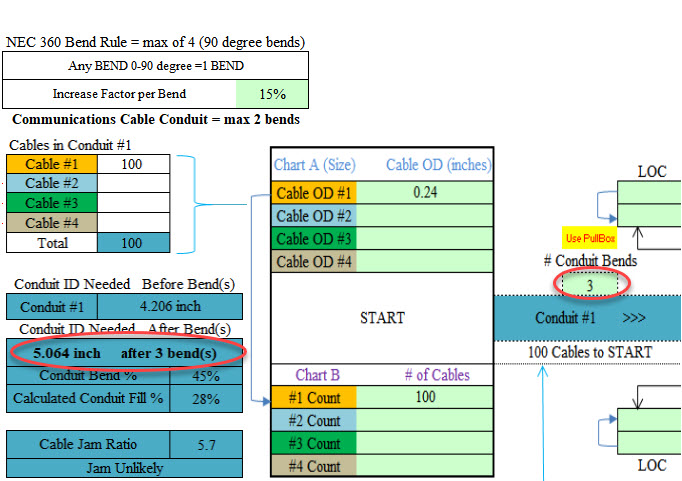

sheet. Can you design a sheet for the EIA/TIA multiple cables? |
|
We
are using TrakPro, see below, and was wondering how we can make
the 28.3% gross profit margin project look like we made a 30% GPM?
We can finish the project (20 hours) with an $18/hour guy but that
didn't give us the results we wanted. Please hurry with information! |
|
We are planning
a future multi-story building and want to be ahead of the installation
game. How much conduit
capacity is needed for the CAT6a communications cable? |
|
Our company
utilizes the formula for material sell price as Sell = Cost divided
by 1 minus the gross margin %. BidPro uses a markup % times the
cost. Our formula example for a 40% GPM: the $100 cost = $166.67
sell. BidPro shows a 40% markup so the sell price is $140.00.
How can we reflect our Accounting requirements in BidPro? |
|
There is an
existing empty 4" EMT conduit that has 3 - 90
degree elbows. The customer asked us to use this existing
75' conduit (due to budget constraints) and install 70 - 0.24"
OD cables? |
|
Whom do you
recommended as a supplier for communications cabling products? |
Question
24: |
I have a business
that arranges flowers for weddings. I can't seem to make money
on this venture because soooo... many people compete in that field.
I love what I do but cannot continue to break even or loose money.
What can your software do for me? |
Question
25: |
We are using
your ConduitPro to determine conduit capacity. Your special fill
sheet can calculate up to 4 different cable types, we have a need
for 6 to 8 different groups. Can you help? |
Question
26: |
Can we use BidPro in a Hollywood film making project? |
Question
27: |
We use CablePro and want you to add a graphical depicting of our bid material &
labor figures. How do we go about asking for an upgrade? |
Question 28: |

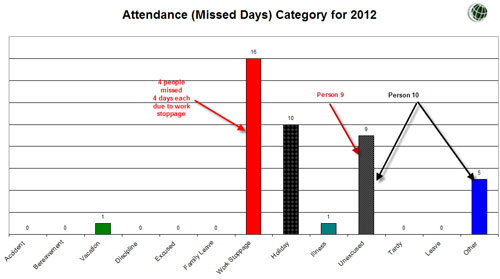

Walk me thru LaborPro.
As an example: I have 10 people I want to track per project. We
have 40 hour work weeks (when business is good) but we have do
not have paid holidays or vacation days. |
|
|
Question
0: Your product
works with Microsoft's Excel. I have Excel as part of my Office suite
of products but do not have the time or the desire to learn how to
really use this program. Should I skip your product and look for
something similar that is easier to use?
Peter Buitenhek Answer: You will not find
any product that does all the things our's can do. Our products
use Excel because it has worldwide acceptance. The beauty
of Excel
is that we made it look like a typical input sheet that will give
you the results you want without having to program or understand
formula structure.
As

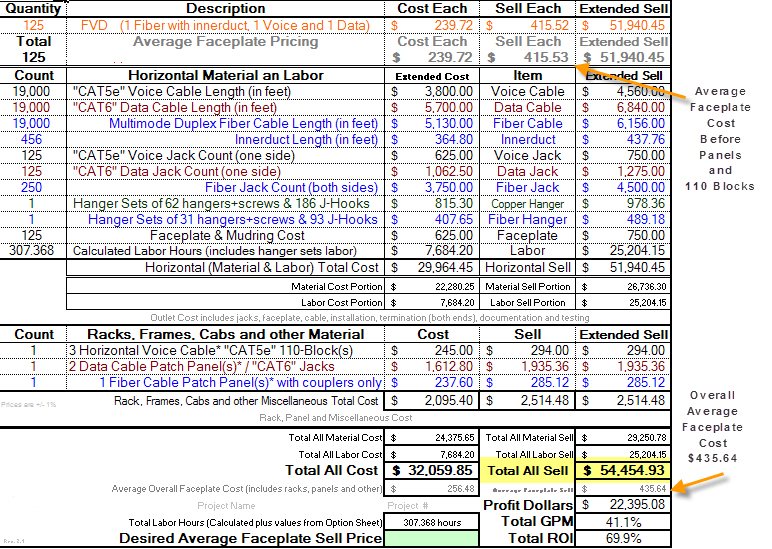

an example: using our program called, CablePro (determines

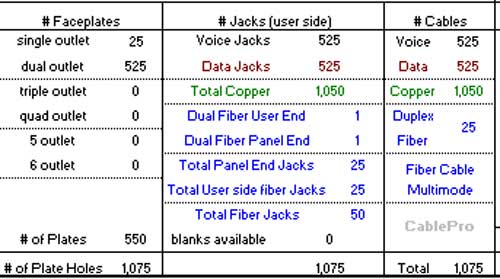

product quantity, cost and sell price of a horizontal communications
cabling
project) and the Baseline parmeters: you only need to enter one (1)
item to get the following results.
This
is the entry area where you want to enter the quantity of Fiber - Voice
- Data jacks You
enter 125 FVD (Fiber-Voice-Data) faceplates. Based on normalized data,
you get:
On
this project you would bid $54,455 and make about $22,395 profit.
Most contractors just seat-of-the-pants bid $450 per 1Voice/1Data/1Fiber
faceplate ($450x125=$56,250), you should have a bid margin advantage
because the average sell price is nearer to $436. Also construction
loan applications tend to go easier when the bank
or
financier sees
all
costs, sell
price
and
Gross Profit
Margin.
So
you see there is no need to understand Excel, but you must understand
your
product:
how
it
is
bid and what
your
financial
needs
are. By the way, this bid took less than "20 seconds". return
Question
1: I have a service and associated product material; what should I
sell it for?
Peter Buitenhek Answer: It depends on your customer’s
perceived value of the product/service and your company’s profit expectations.
If your financial people do not dictate a specific profit margin, pick
32%. This magic number has made many companies very rich. Remember the
formula for GMP % = Sell minus cost divided by sell times 100%. return
Question
2: What profit does my competitor have on the same service & product
we provide?
Peter Buitenhek Answer: Ask them! Or use BidPro to determine what your gross profit margin would be if you sold your
product & service at their asking price. Using BidPro will allow
you to do a Best-and-Final (BAF) where the customer is "looking" for
a specific sell price. It quickly "reverse engineers" the numbers
to determine what your profit would be if you use the new sell price. return
Question
3: I get $944.08 profit on each product I sell, is this a moneymaker?
Peter Buitenhek Answer: Profit is always good.
However, what is your product cost? response - $1,256.18.
Peter
Buitenhek Answer: If the product costs
you $1,256.18, then the sell price would be $2,200.26 at a gross
margin of profit (GMP) of 42.9%. Any company would love a GMP over
40%; most companies have numbers ranging from 10% - 30%. However,
if for example, your cost of the product was $12,561.80, the sell
price would be $13,505.88 at a GMP of 7.0% - that would not be
a moneymaker. return
Question
4: So GMP is very important to the company’s financial strength. Does
the product cost change if my company asks me to sell the product at
a specific price or gross margin?
Peter Buitenhek Answer: Not if your costs are fixed. Examples of costs
are: material cost, labor burden rate, direct job overhead cost, bonds,
parking, permits, per diems and more. return
Question
5: My company wants to make good profit but does not insist on a specific
GMP or sell price. They rely on me to set the sell price. However,
my costs are not fixed. In addition to the usual material & labor
costs, I sometimes need to pay parking and subcontractor costs, other
times I pay only freight charges. How does this affect the GMP?
Peter Buitenhek Answer: Use BidPro and set up each
project with a specific GMP or sell price in mind (say 32%). This way
you are assured a specific forecast profit. Each project should always
have a good profit story to talk about at raise time. Remember Babe Ruth
pointing to the right field where he was going to hit that home run!
Upper management is impressed if you point to the profit dollars and
deliver that amount. By the way, I don't mean fleece the customer, I
am an advocate of a good job performed at a fair price! return
Question 6: Assume
I bid a project at a specific sell price, and downstream I find additional
costs that I did not count on. How will this affect GMP?
Peter Buitenhek Answer: The GMP would decrease
by a calculated amount. If this difference is negligible or within
tolerance, you may not need to worry. I always allow some product pricing
or labor slop for that reason. If the variance is not within tolerance,
management needs to be apprised immediately! However, if the bid is
very competitive, extra pricing slop may put you over the winning bid
so use caution. return
Question
7: So if I use lower raw-labor rate people to complete the job, the
increased costs mentioned above may be offset by the cost decreases
from labor?
Peter Buitenhek Answer: Project Cost Management.
If for example you bid $18.57 per hour labor people and ended up using
$15.78 per hour wizards, you could possibly offset the cost difference.
Or, you might be able to buy that special tester, at $4,857.58, and still
bring the project in at 30% GMP. TrakPro can handle all those conversions
easily. People will be impressed. return
Question

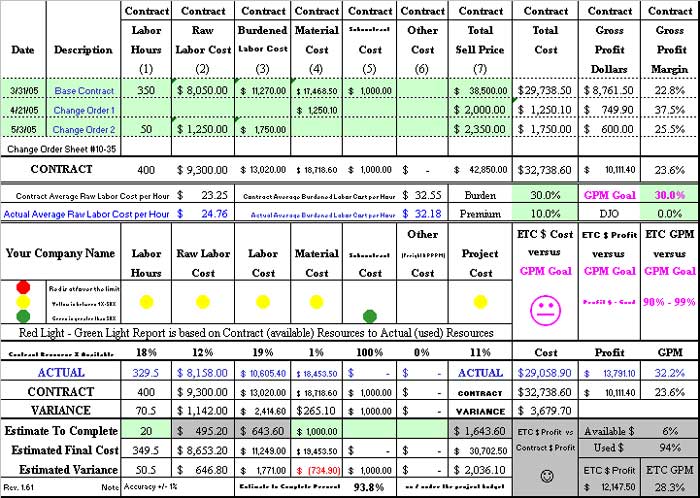

8: How does your cost chart work in TrakPro?

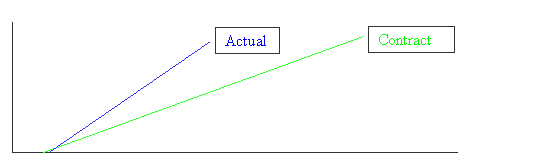

Peter
Buitenhek Answer: The Contract cost is shown across the (x-axis) baseline
and extends left-to-right. After the project starts and actual costs
start to accrue, a secondary line (blue) is added to the chart to depict
cost relationship. If the actual line costs are to the right (below)
of the contract line, the labor, material, subcontractor, and other
project total costs are all within contract goals:

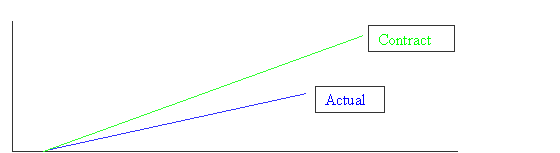

If
any category costs are to the left (above) the contract goal, the actual
line will fall to the left of the contract line signifying you are
above contract cost. This easy-to-see graphic format is great for assessing
many projects quickly.
return
Question
9: Along that same line as question #8 above, how does TrakPro handle
the estimate-to-complete (ETC) cost projection?
Peter
Buitenhek Answer: A tertiary line is added when Estimate-to-Complete
(ETC) costs are forecast for project completion. If the ETC line falls
below the contract line, the final costs will be below contract goals
(yea). Conversely, a line above the contract will signify costs above
the goal and suggests cost-saving or limiting measures should be implemented
by management.
The
process of viewing the line chart is a favorite for most companies.
The question at all staff meetings reviewing projects invariable states, “Are
we below the line? If so, next project.” return
Question
10: In TrakPro, what is the "Over/Under Minimum Billing Amount" and
what is it used for?
Peter
Buitenhek Answer: Like my previous boss, George Harris, always said, "Hello!"
You
need to stay profitable on every phase of the project. Look at the
ratio between year-to-date actual plus ETC (estimate-to-complete) costs
and compare this to the contract cost amount to determine how far along
you are on the project. If you have used 50% of the costs then, hypothetically,
you are 50 % done. Therefore, you should be able to bill a minimum
of 50% of the total contract "sell" amount. TrakPro compares
what you have billed and what you should bill to give you an "over/under" billing
dollar amount.
Assume
your costs are $365.75 and you have billed the customer $500 contract
cost. You are $134.25 over billed. If the customer has paid the $500
invoice, then your cash position is $134.25 over cost. These "over
cost" dollars thrill bankers and can be used to fund other projects
without mixing project accounting funds. return
Question
11: In TrakPro, what is the function of the WIP Sheet?
Peter

Buitenhek Answer: The WIP (work-in-process) Sheet depicts your project
standing in cost, profit, minimum billing and cash position. It breaks
down overall material, labor and other costs and presents a hypothetical
Time & Material (T & M) rate for reference.
TrakPro WIP then provides 3 Options for similar projects:
Option
2. What if we were to fix the material markup costs and/or Labor Rate
(T & M)?
Option
3. What if we were to fix the material sell amount?
OPtion
4. What if we were to fix the labor sell amount?
Example:
the customer has numerous similar installations and the previous contractor
typically charged $500 total for labor. The customer became disenchanted
with the current contractor, for whatever reason, and has asked you
to bid the project with the proviso that the labor dollar amount be
similar. You estimate the project, lock in the Labor Sell Amount, and
decide at what GPM you want to bid the project.
A
WIP chart will depict cost, sell price and profit dollars.
return
Question
12: I have many technicians (at different pay grades), many products,
different configurations, variable timeframes and more. How do I calculate
the sell, GMP, billing and cash position numbers easily and quickly?
Peter Buitenhek Answer: The best solution:
BidPro & TrakPro from http://www.bidqwik.com return
Question

13: A 3" diameter EMT conduit we want to use already has 2 sets
of cables (10 cables @ 0.2" dia. and 5 cables @ 0.31" dia).
We want to add 43 cables @ 0.26" dia. Will we still be to standard
at the 40% max fill?
Peter Buitenhek Answer: Yes, a simple problem
for ConduitPro. The calculated fill percentage is 39.5% for the 58
total cables in the 3" conduit. The cable area is 2.9745 sq."
in the useable conduit area of 7.523 sq.inch at the 40% Standard.
return
Question
14: Please

help with the bid price for the following: 525 new CAT6 V/D runs
and 25 new fiber locations. All are at an average 200' distance
from the MDF except 3 fiber runs that are 250 feet station distance.
All voice/data/fiber cables land on patch panels.
The CAT6 cable costs me $0.23 per foot, the multimode fiber
cable
is $0.38 per
foot, the rack is $180. The 96 port data panels cost $878.40
each, 12 port data panels $121.80 and the 48 port fiber patch
panel is $134.40 each (with couplers only,unterminated). I mark
up my material 20% and my burdened labor is $26.00 per hour and
the labor sell price is around $54.00 per hour.The customer wants
20% growth on the panels. Can you help?

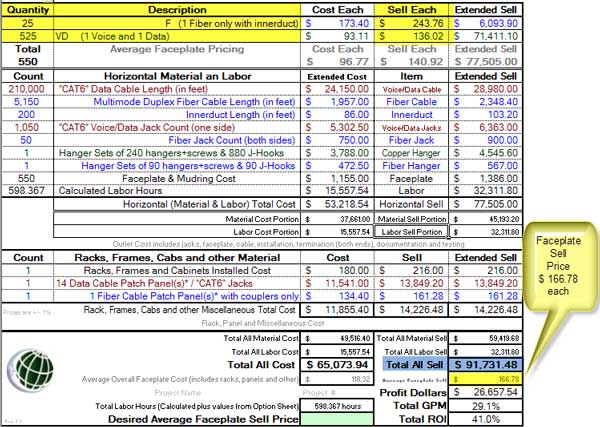

Peter Buitenhek Answer: Yes, let's

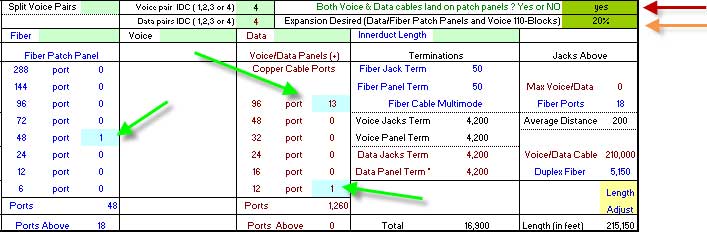

use CablePro. You did not mention rack cable
management so I assume there will be none. We will enter 525
Voice-Data 2-plex faceplates and 25 fiber simplex faceplates
Each
faceplate combination is broken down by cost and sell pricing.
Most contractors feel
the sell price for a voice/data drop ($136.02)
and a single fiber drop ($243.76) are too low, opting for the
seat-of-the pants $200 per V/D drop
and $300 for
a fiber. But after using the CablePro, many
contractors can actually
see their "real" average costs are a lot lower
($96.77 average cost). For this reason,
all applicable costs are
added to CablePro:
cable, jack, hanger, faceplate, rack, block and panel pricing.
Installation
labor, documentation and testing are also added at the user
specific rate. The Sell Price for you is $91,732.
525
duplex faceplates
|
As requested
20 % growth on the panels
|
330
Hangers+330
screws+970 J-Hooks
Cost $4,260.50
|
25
simplex faceplates
|
|
Labor
hours - 598.367 hours = Cost $15,557.54
|
Innerduct Cost
= $86.00
|
550 faceplate & mudrings
|
Overall
Sell Price - $91,731.48
|
Average
cost per faceplate - $118.32
|
Total
cable length - 215,150'
|
Gross
Profit Margin (GPM)- 29.1%
|
Average
sell price per faceplate - $166.78
|
|
Return
on investment (ROI) - 41.0%
|
15
Patch Panels & Rack $11,855.40
|
|
Profit
dollars - $226,657.54 |
Overall
Cost $65,073.94 |
|
|
|
|
Total
time to do this bid = 2 minutes |
|
|
|
|
Question
15: I notice many questions relate to computer cabling projects,
does your software handle different business projects?
Peter
Buitenhek Answer: Yes, originally all programs were developed
for the cabling industry. There are five (5) software projects
that we market; three (3) have been redesigned for any business
(BidPro, TrakPro and AttendancePro), the remaining two
(2) have stayed strictly for the horizontal cabling industry
(CablePro and ConduitPro).
We
also do custom projects on occasion. We have developed a
proprietary FuneralPro were the funeral
director can enter all pertinent information after the interview
with the family. The program ascertains if all items have
been covered, calculates costs and prints the death certificate.
This prevents embarrassing come-backs. return
Question
16: Do I need to update your programs regularly to keep them
current? Do I need to buy additional copies or licenses to
run your program on my work and home computers?
Peter Buitenhek Answer: Both are
- No!
All
information that you enter into the programs are your current
product-project related items. Each program calculates the
complex results using your figures. All formulas and graphs
are available through the standard Microsoft-Excel program.
To
stay ahead of the competition, we do our work at home as
well as at work. Use as many copies
as required to make your business profitable. If you need
copies
for
additional salespeople, do so. One famous software program
developer (unnamed) uses our software structure from
two programs as an underlying calculation engine for their
software.
Everyone
that purchases our programs makes money consistently. We
have priced these programs ($40 - $80) so you can make your
money back ..........in just one project ! return
Question 17: Your logo is a moon overlooking the earth. Is
there any significance to that?
Peter
Buitenhek Answer: Yes, I am an amateur astronomer so the
original logo was a lunar eclipse. The
Earth depicts the P in Profit
and the eclipsed moon is the D in Developer. The dot com
(.com) was not easy to see.
The
lunar eclipse can only occur at Full Moon and only if the
Moon passes through some portion of the Earth's shadow. When
an eclipse of the Moon takes place, everyone on the night
side of Earth can see it. About 35% of all eclipses are of
the penumbral type which are very difficult to detect, even
with a telescope. Another 30% are partial eclipses which
are easy to see with the unaided eye. And the remaining 35%
are total eclipses. Similar to these cycles, my software
originally was geared to provide a profit in the 30-35% range
when all
contributing
factors were met.
As
the programs matured so did the logo. The current logo has
taken on the color of money (green) which is the driving
factor for my programs. In addition, it is also the color
of the Universe when viewed
through
the largest spectroscopic survey
completed to date. Astronomers Karl Glazebrook and Ivan
Baldry of Johns Hopkins University, conducted the Two Degree
Field (2dF) Galaxy Redshift Survey and calculated the current
"cosmic spectrum" is a greenish hue. This galactic glow
was considered bluer six billion years ago when the stars
were
younger. The current pale green will become redder as the
stellar population ages. return
Question

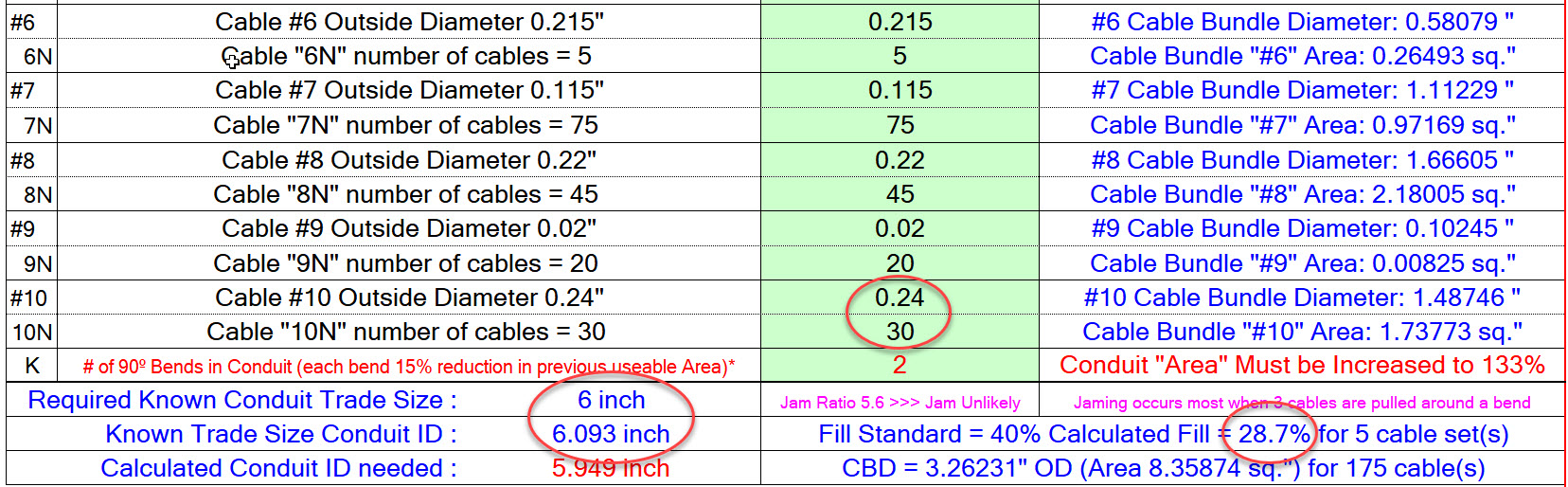

18: Peter we have a 5" EMT conduit that has the following
existing cables (50-0.215" OD, 75-0.115" OD and
45-0.30"
OD). We want to add 45-0.24" cables to this conduit, will
we still
be to the 40% maximum fill standard? We see that your "Peter's
Fill" sheet in ConduitPro has the multi-cable calculations
but not the EIA/TIA sheet. Can you design a sheet for the
EIA/TIA
multiple
cables?
Peter
Buitenhek Answer: Both the EIA/TIA and Peter's Fill sheet
abide by the 40% fill criterion. Originally EIA/TIA wanted
any
technician to be able to easily calculate cable areas and
fill quantities
so they used general number. The area of a cable (or conduit)
by EIA/TIA standards is calculated by squaring the diameter
and multiplying this by 0.79 then rounding to the 1/00
position. Peter's Fill sheet uses radius squared times
Pi (3.141592653589)
and rounding to the 1/1,000,000,000 position. This
equates
to the
following: a 0.24" OD cable by EIA/TIA standards has
an area of 0.05 sq.inch and Peter's Fill is 0.045238934
sq. inch.
Peter's Fill is no different, just more exact and accurate.
I
added Item1 of Peter's Fill because that is what we saw
in real life. The EIA/TIA & BICSI Standards did not have
any
multi-cable calculations. Perhaps we should ask the standards
people to incorporate the multi-cable layout!
Conduit
OD can be user changed at the Conduit Sizes sheet.
So I made
the 5" NEC Conduit size the same size as the EIA/TIA
size (5.05" ID). I then plugged in the cable fills and
came up with the following:
So the 45-0.24" OD cables will fit (39% fill) into the 5.05"
ID conduit and still be to the 40% code (actually 49 cables
will fit and
be to
code). As a bonus, I have included Peter's Fill using the NEC
sizes as a comparison so you will see that 51-0.24" cables
will be
to
code.
return
Question
19: We are using TrakPro, see below, and was wondering how we
can make the 28.3% gross
profit margin project look like we made a 30% GPM? We can
finish the project (20 hours) with an $18/hour guy but that
didn't give us the results we wanted. Please hurry with information!
Peter
Buitenhek Answer: I do not recommend changing your baseline numbers.
It makes project estimate comparisons really hard to normalize.
After our telephone conversation, it was determined that
the
company
desired
profit margin
is
30%
and good
things happen at that rate. Because of a competitive situation
you bid the project at 23.6% GPM so I assumed that you
were required to make up ground as you go.
First:
Your average actual raw labor rate is $24.76 per hour but
you bid less expensive people ($23.25/hr)! However, you made
up ground on the labor hours by saving 50.5 hours. Your decision
to use an $18.00 per hour person (lowering the actual raw
cost to $24.37) is sound advise as long as
this
person
can
meet
the
20 hours
to complete
requirements.
Second:
Your actual GPM is 32.2% and it dropped to 28.3% after your
estimate to complete $1,643.60. Your are $734.90 over your material
cost estimate and have $1000 available for the subcontractor
so you missed the actual material mark by over $1700! Can
you trim the $1000 material estimate-to-complete cost? response
- No.
Finally:
If you use the lower priced person and lower your 30% burden
rate to 24% it will work. Your final profit dollars will
be $12,834.18 which is higher than the $10,111.40 you bid.
Keep in mind that if your "real burden rate" is
actually lower than your 30% bid, you would probably win
more projects (lower
bid price).
So the end result shows a 30% gross profit margin after the Estimate-to-Complete. return
Question
20: We
are planning a conduit rough-in for a future multi-story building
and want to be ahead of the installation game. How much conduit
capacity
is
needed
for the CAT6a communications cable?
Peter
Buitenhek Answer: You are referring to Augmented
CAT6 UTP (CAT6a) cable
which, in 2006, is being considered in draft status by
the IEEE 803.2an Standards Committee
looking into 10GBase-T Ethernet at 100 meter versus only
37 meters for CAT6. The main issues still deal with properties
of shielded twisted-pair
(STP)
CAT7
cable versus familiar unshielded twisted-pair (UTP) CAT6a
cable. Regardless of the choice, I do not believe they
will change the max 40% fill ratio for 3+ cables. As such,
a 1-1/2" EMT conduit will support 8-CAT6a (nominal
outside diameter 0.35") cables versus 20-CAT6 (0.22"
OD) cables. A 2" EMT will support 13-CAT6a or 34-CAT6.
And for fun, 16-CAT6a and 20-CAT6 will fit into a 2-1/2" EMT
at 39.3% fill. return
Question
21: Our
company utilizes the formula for material sell price as Sell
= Cost divided by 1 minus the gross margin %. BidPro uses a markup
% times the cost. Our formula example for a 40% GPM: the $100
cost = $166.67 sell. BidPro shows a 40% markup so the sell price
is $140.00. How can we reflect our Accounting requirements in
BidPro?
Peter
Buitenhek Answer: Option 2 of the Margins Sheet allows
fine tuning of the 20 cost categories. Simply enter your
desired gross margin.
return
Question
22: There
is an existing empty 4" EMT conduit that has 3 - 90 degree
elbows. The customer asked us to use this existing 75' conduit
(due to budget constraints) and install 70 - 0.24" OD cables?
Peter
Buitenhek Answer: You did not indicate if the EIA/TIA Standards
police was involved because we all know that they do not
allow more than 2-90 degree bends without a pullbox. That
said, each 90 degree bend reduces the
conduit's capacity to carry cables by roughly 15%. Thus,
3 bends will decrease
the
capacity 45% (15%+15%+15%). Assume a conduit has 100% capacity
with no bends, the resultant is 100% - 45% = 55% capacity.
The Standards indicate that 3+ cables has a maximum capacity
of 40%. Using both these restrictions, the conduit "should
have" 40% x 55% = 22% capacity or 71 cables maximum.
return
Question
23: Whom
do you recommended as a supplier for communications cabling products?
Peter
Buitenhek Answer: Yikes, a political question!
Supplier:
My #1 pick
for supplier has always been Graybar for their people,
product support and consistent low prices.
Anixter
is a close #2 with people, product knowledge and major
account pricing structure. However, since my office was
a regional
location,
I was not credited with
the Anixter
Corporate Discounts so I was left with much higher prices
to compete against local corporate companies with discounts. Now
product: Many years ago we had some technician time on our
hands so we
devised an unscientific test to determine which communications
cable was the best. Again politically speaking, we tested
5 major brands of cable at 152 feet distance where:
1-we
tied it in a tight figure 8 knot
2-wound it around a running
drill and vacuum cleaner motor
3-placed
it over
a door jam
and
sat
on both ends to form a U crease
4-ran it around a nail
pickup magnet.
Now
be advised, we do not utilize gorillas to install our cabling,
but sometimes we receive a cable box or reel where we notice
a crimp in the cable or when we pull the cable above the
drop ceiling it wraps around a ceiling wire. The magnet
and drill windings was to simulate running cable near an
HVAC motor or static air plenum. In any case, we
ran our CAT5 tester (yes I know it dates
me) for compliance and the following unscientific test
results were found:
-four (4) cable brands failed the tests and one passed
(Belden). return
Question
24: I
have a business that arranges flowers for weddings. I can't seem
to make money on this venture because soooo... many people compete
in that field. I love what I do but cannot continue to break
even or loose money. What can your software do for me?
Peter
Buitenhek Answer: Assuming you are breaking even or losing
money because you must bid that amount to get the business,
see Item #1.
If
you are bidding too low and don't account for all your
costs
(flower
costs,
delivery, insurance, spoilage, etc.) see Item #2.
Item
#1: Work
with your flower supplier and other subcontractors to
get a better price for their product/service. Tell them
you
want to remain in business and want to use them many
more times...if they can cut their cost 10% for the next
6 months.
Make sure you have entered all your known costs in BidPro and
keep the desired GMP at 27.5%. Also see if you can
team with another wedding flower arranger to provide
your service, or vice versa. Show them BidPro to let
them determine
their GMP. "Take a leap and the net will appear"
Item
#2: Know
your costs and know how much to charge to get your profit margin
at 30%. In the one case you provided me; you had the flowers
shipped next-day-air to make sure they would arrive on time and
then had them sit in the cooler for 2 days. The bride knew you
were ordering these special Hawaiian flowers for her but she
really didn't pay anything extra to get them...you did. I know
you promised them and your integrity was at stake, but most people
will pay for a good service if they are reasonably sure that
you can deliver. Don't sell yourself short. If bridezilla is
looking for the rock-bottom price, present the product at your
desired GMP and "sell not discount" your intrinsic
value!
return
Question
25: We
are using your ConduitPro to determine cable capacity. Your
special fill sheet can calculate up to 4 different cable types,
we have a need for 6 to 8 different groups. Can you help?
Peter
Buitenhek Answer: We have added an additional sheet to
ConduitPro that can handle up to 10 different
cable types
and have even added reduction factors for the number of
90 degree bends found in the conduit. return
Question
26: Can
we use BidPro in a Hollywood film making project? Peter
Buitenhek Answer: Absolutely. BidPro is designed for any
product/service project or program. If you have a specific
requirement, like Hollywood
Film making, let me know and
I will provide a separate information sheet based on your
requirements. return
Question
27: We
use CablePro and want you to add a graphical depicting of our
bid material & labor figures. How do we go about asking for
an upgrade?
Peter
Buitenhek Answer: A simple email to us
will start the process. The success of our programs have
come about by adding to the software packages specific
user desired options. So here are some additions:
1.

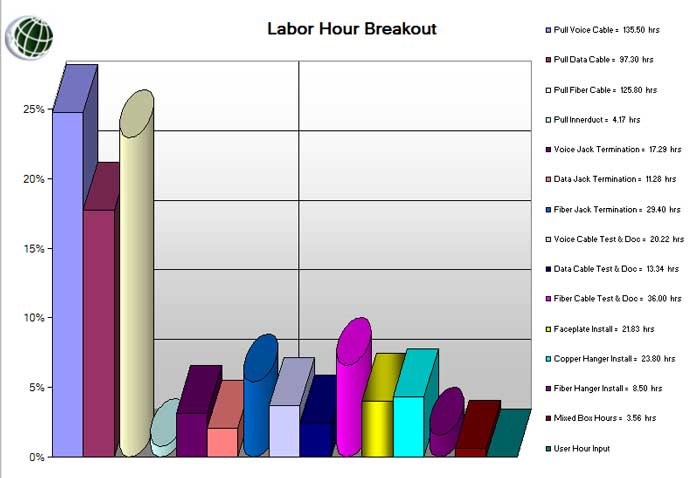

Cost Chart to depict all known labor & material entries:

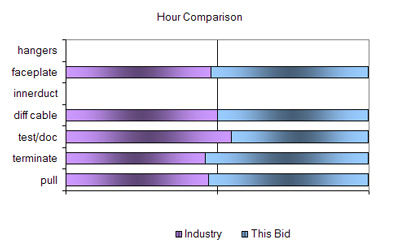

2. Labor Chart to depict all known labor entries:

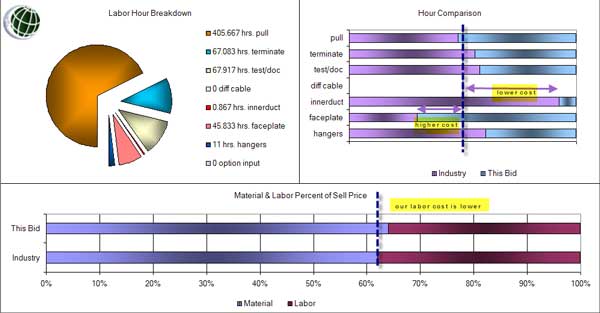

3. Average Chart - a three (3) part Chart
(a) Labor Hour Breakdwon Pie Chart.....(b) Hour Comparison
Chart

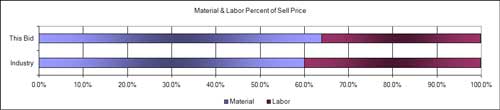

(c) Material & Labor as Percent of Sell Price
In addition, a request was made to add a simple cable
install button that would calculate material & labor
hour costs based on cable pull times, termination (both sides),
test & documentation.
No wire hangers, innerduct or panels/blocks. This
button would over-ride the standard CablePro calculations
without zeroing out those values.
Arggghh. It goes against
my grain to quote an incomplete install but...
The
button (located on the Faceplate Sheet) will zero out all none
basic values
and inform you of same. All charts would reflect zero or blank
values.
Question
28: Walk me thru LaborPro. As an example:
I have 10 people I want to track per project. We have 40 hour
work weeks
(when business is good) but we have do not have paid holidays,
sick days or vacation days.
Peter
Buitenhek Answer: Let's set up this scenario: Note: each person
can have a name in the program but for this example it's 1, 2
etc.
Week
One
1. Person 1 works 3 days, uses 1 holiday and 1 vacation
2. Persons 2,3 and work 4 days each and each uses 1 holiday
3. Person 5 is assigned to work 3 days but only works 1/2 days,
uses 1 holiday and 1 illness
4.
Persons 6, 7, 8 and 9 have zero (0) work that week due to work
stoppage problems and all use 1 holiday
5.
Person 10 was assigned to work 3 days but failed to show, also
use 1 holiday
Week Two
1. Person 1 works 5 days and has 10 overtime hours
2. Persons 2 - 8 work a full 5 days
3. Person 9 was scheduled to work the whole week but failed
to show
4. Person 10 was scheduled for the whole week but only worked
half days
Assume a 40 hour work week
Input
Sheet. Note: We defined a normal man week (work week) as
40 hours. We want to see how each person stacks up to that
plan
and
how
they compare to each other (for raise & promotion reasons).
1. Person 1 = Since your company does not pay for holidays,
vacation days and illness that person should not be "judged"
on a 40
hour work week. Person 1 took 1 holiday and 1 vacation day
then worked 3 - 8 hour days. Therefore: 3 x 8 = 24 plan hours.
The "P" designator is for partion or part-time hours. Hence,
24P24 represents 24 hours worked out of a possible 24 hours
planned. On week two (2) that person worked a standard 40 hour
workweek plus had 10 hours of overtime (50). For visual clarity,
this could have been written, 50P40, but either will work
2. Person 6 thru 9 did not have work that week and should not
be penalized in effort.
3. Person 9 = was scheduled to work week 2 but failed to show.
Hence zero (0) hours.
4. Person 10 = was scheduled for 32 hours but failed to show
on week 1. On week 2 they only worked 1/2 time.
5. Each other person worked the planned 40 hour work week.

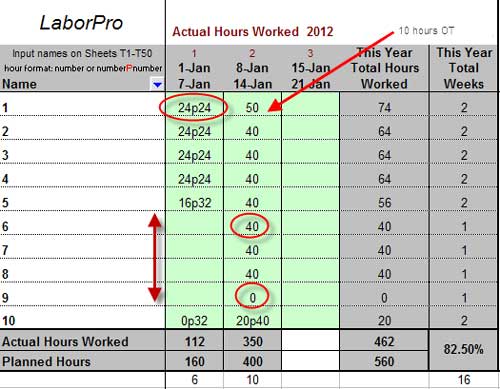

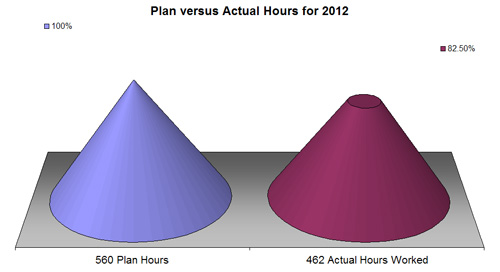

Out of 16 work weeks, actual work hours were 462 hours out of
the planned 560 hours, thus running at 82.5%
The

line chart will display "ABOVE or BELOW" the planned labor hours.
Many companys
have indicated that they are very pleased
with visual ease of this chart when discussing tens of projects.
Note: this chart will get very busy with year long projects
(52 man weeks).
We
next observe the "EFFORT" portion of this project. Out
of the 16 working man weeks, Person 1 had ten (10) overtime hours
within a 2 week work cycle. Person 10 had one week less than
planned and
1 week absent or "sitting on the bench" doing nothing.
This
same information is depicted in the Compare Chart. The center
line (midpoint)
of the chart signifies being on plan. To the right indicates
overtime; to the left indicates under planned time. This could
be good or bad. If you are on target with the project scope while
using less labor hours...more profit for the company. Note
Person 9 has worked zero (0) actual hours!
The Labor Chart (overview) incorporates the typical quick
look at how well our people are being managed.
Now finally comes the "Attendance" portion
of LaborPro. There
are 10 people that we want to manage (50 max). Each persons weekly
absences are entered as follows:
Person 1 took 1 holiday and 1 vacation day, then was available
for work for the next 8 days.

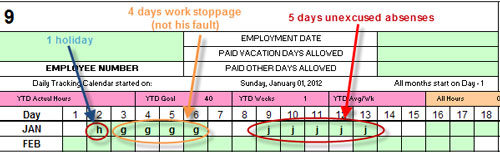

Person 9 took 1 holiday and missed 4 days due to work stoppage
(not his fault) the missed the entire week even though he was
scheduled to work 40 hours.

Person 10 took 1
holiday, then missed 3 days of work in week 1. Then only
worked 1/2 time for the 2nd week even though scheduled
for 40 hours.
The
overall absence overview is visible on the AttendanceChart
Armed with this

information you call Person 10 into your office to ascertain
why 9 days of work were missed. You show that
person the Total Work hours (although not as low as zero from
Person 9) that places him near
28% effort. The mini chart defines lowest, average
and
max work percentage and compares Person 10 with all others.
The example listed above may seem a bit extreme
but it really did happen when I took over a new office many
years
ago. Through LaborPro we were able to determine the top performers
and weed
out the
low performers and set them on a proper employment path.
The
other classic example involved several of my top performers
who had many many hours of OT. During a career review on one
such person,
they where looking for a significant bump in wage. However,
the LaborPro showed that the equivalent hourly wage was even
higher
than they
expected. And secondarily, we trimmed expenses because we placed
a junior technician with the senior instead of two (2) seniors
getting overtime wage rates.
I
trust that this answer, although lengthy, did provide the
LaborPro advantages for project and program managers.
return
back to top
©Copyright 2023 BIDQWIK™.COM
All Rights Reserved
No use of information without express written permission|
from Peter Buitenhek
|
|
