Return
to BidPro Design
Margins
Sheet
The
Margins Sheet is where all the "pizzazz" takes place. The
sheet is broken down into 7 options:
|
1.
|
Option
1 is all the category cost, sell, GPM and total information
as provided by you. The Parameter Sheet, Labor, Material and
Summary have all your project/company specific information.
BidPro will have calculated all pertinent Raw, Burdened and
Sell Labor costs.
|
|
2.
|
Option
2 is the What-ifs GMP section that allows specific area changes
to their gross profit margins
|
|
3.
|
Option
3 allows a total project Desired GPM
|
|
4.
|
Option
4 designates your desired project sell price in dollars
|
|
5.
|
Option
5 is the Gold-Standard set for your company that all projects
must adhere to or be subject to management approvals.
|
|
6.
|
Option
6 is the Change Order (T & M) portion that allows encapsulation
of all categories into Material & Labor Markup Percentages.
|
|
7.
|
Option
7 allows you to pick the appropriate option (1-6) and displays
that total by category. It will feed the Customer Sheet (no
costs shown only sell price) and allow copied input of specific
values into Profit Developer's TrakPro Software.
|

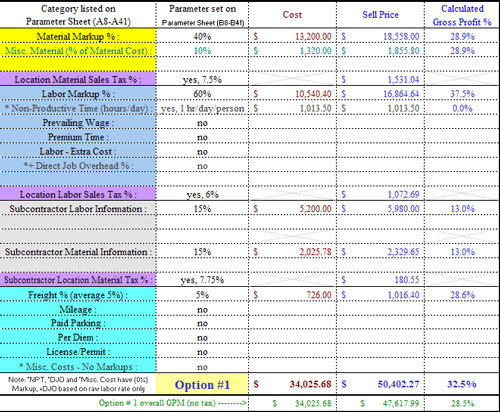

Option
1 Project Specifics

Option
2 What-if GMP

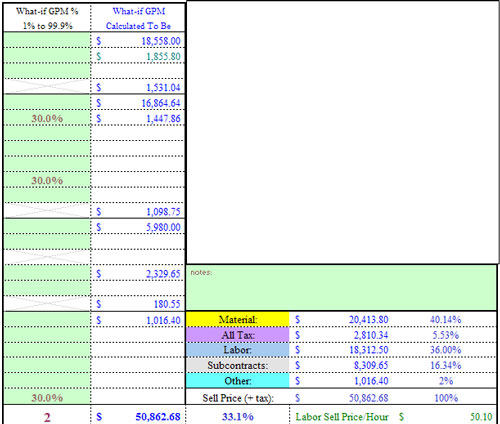

In
the Option #2 example we have changed 3 items. However, only
one item, NPT will be marked up from 0% to 30%
1.
Non-Productive time was 0% markup to 30% GPM
2.
Direct Job Overhead (DJO) was 0% and now is 30%
4.
Misc. Costs was 0% and now is 30%
The
resultant action brought our sell price up to $50,862.68 from
$50,402.27. The GPM
went to 33.1%.
In
this example, Material items accounts for over 40% of the total
sell price. As before, these percentages vary from project
to project, I have found a sense
of category proportions developing over time that may trigger
a closer look into your project specifics.
|
Option
3 Desired Gross Profit
The
desired sell price is based on an overall GPM of 30% (before tax):
The

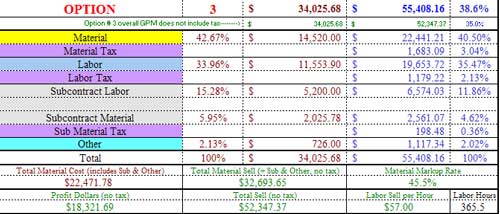

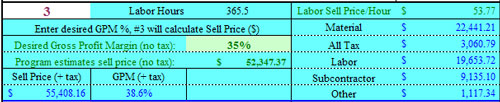

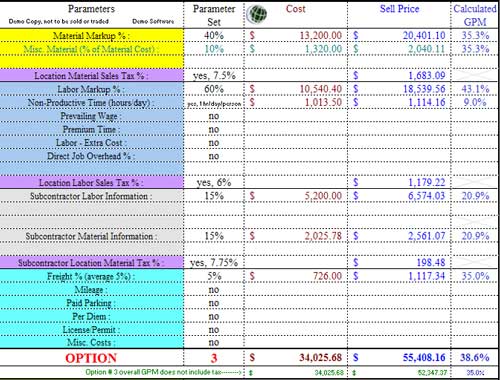

resultant cost/sell item breakdown for Option #3 is below:

|
The
sell price would be $55,347.37 at 35% Gross Profit (before tax)
and $55,408.16 after tax. |
In
the above example, Material items accounts for nearly 43%
of the total sell price of $55,408.16.
The
corresponding Labor Sell rate is calculated at $57 per hours
which does not include subcontractor labor hours.

|
Option

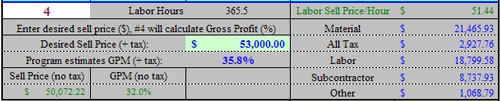

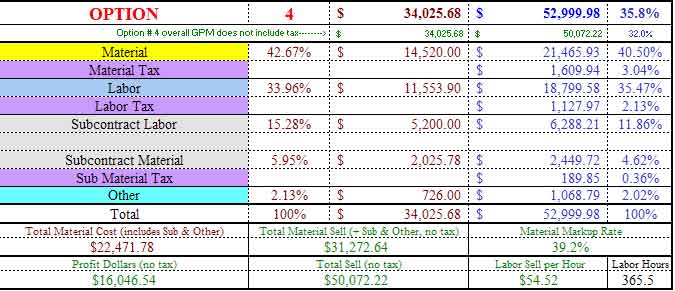

4 Desired Sell Price

In the example above, the desired
sell price has been set $53,000 (tax included)
|
The
desired sell price of $53,000 was entered in the green area.
BidPro has a plus/minus +/- backward calculation accuracy of
1%. Hence, you may see a different or recalculated BLUE Desired
Sell Price if it could not hit your exact desired sell price.

|
In
the above example the sell price is $53,000 (+/- 1%) at 35.8%
GPM. The Labor Sell rate is $54.52 per hour.
|
Option
5 Gold-Standard GMP
The
Parameter Sheet has set your company's desired gross profit
on any project. Regardless of the different option inputs
on the Margins Sheet: this item will always show your "Gold-standard".

|
No
separate category breakdown is provided with Option 5 since
this is the target area. You could set Option 3 to 30 % GPM
or Option 4 to $50,072.22 if the exact figures are desired.
|
Option

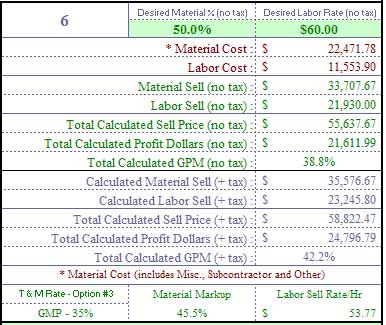

6 Change Order
Let's
look at this project in a Time & Material rate basis. Assume we want
to bid a Material Rate of 50% markup and a Labor Rate of $60/hour (all
before taxes). The Total Sell Price (before tax) is now $55,637.67
which would yield a 38.8% GPM.

After
you decide on which option best fits your proposal, BidPro

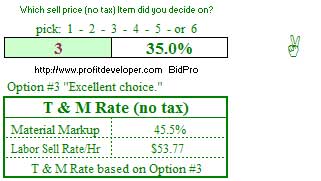

will provide a visual feedback of text and a graphic symbol.

|
The
26 written feedback responses ("Excellent choice") are user adjustable
(look at column BE) |
|
TrakPro
Information
TrakPro
is software available through Profitdeveloper.com that tracks
a bid versus actual costs and determines: actual profits, bid
to actual costs, billing status and cash status.

|
This
tabulated information can easily be copied into a contract
cost tracking program.

The
TrakPro Software is available under separate cover and is used
to track actual labor hours/material costs/other costs and
compare them to the bid (budget) amount to give you an understanding
of bidding accuracy and worker performance. This TrakPro spreadsheet
will require the following input:
- Budget Labor Hours - Budget Raw Labor Cost - Sell Price (minus
tax)
- Budget Labor Cost - Budget Material Cost
- Budget Subcontract Cost - Budget Other Cost

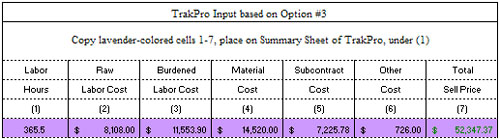

For
more information on TrakPro please see the TrakPro product
information.
|

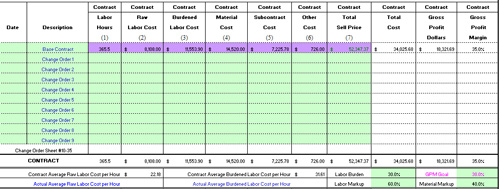

The TrakPro workbook
incorporates twelve (12) topic planning forms. The main forms
are: Summary, Technician, Labor, Material, Subcontract, Freight, PPPM (Parking,
Per Diem, Permits and Mileage), Bonding and WIP.
1. The Summary Sheet
is fed by all other sheets in the workbook. Contract labor,
material, and other costs are input along with the sell price
and expected profits. As actual costs start to accrue, TrakPro compares
bid-to-actual results and expected profits. An estimate-to-complete
line allows project and financial managers to assess project
health. Besides the original contract, TrakPro will
allow up to 35 change orders and will track all appropriate
comparisons.
2. The Technician Sheet
allows input for tracking of up to fifty (50) people. Since
some functions within Excel require a sorted list, these workers
can be input and sorted using Data-Sort feature of the toolbar.
The Labor Sheet allows up to 500 entries for
time and raw labor rates in order to calculate burdened costs.
Hours can be tracked by regular, overtime, double and premium
rates.
3. The Material Sheet
allows up to 500 entries describing vendors, PO numbers, dates,
dollar amounts and a specific notes section for future clarifications.
4. The Subcontract Sheet
allows entries (25 or more) describing subcontractor names,
PO numbers, dollar amounts and a specific notes section for
future clarifications.
5. The Freight Sheet
allows entries (25 or more) describing vendor names, PO numbers,
shippers, dollar amounts and a specific notes section for future
clarifications.
6. The PPPM Sheet
(parking, per diem, permits and mileage) allows entries (25
or more) describing names, type of cost, dollar amounts and
a specific notes section for future clarifications.
7. The Bond Sheet
allows up to 10 entries describing the bond type, internal
bond rate, our cost and a specific notes section for future
clarifications.
8. The WIP Sheet (work
in progress) follows costs, estimates-to-complete, billing
percentages, cash positions and tracks manhours. In addition
to the original contract, the WIP sheet allows
comparisons utilizing Time & Material (T & M) numbers,
and fixed sell amounts for material and labor. In each case,
complete financial status is displayed.

|
Typical
TrakPro input can be from BidPro or input manually.
|
Return
to BidPro Design
©Copyright
2025 BIDQWIK™.COM
All Rights Reserved
No use of information without express written permission|
from Peter Buitenhek |
